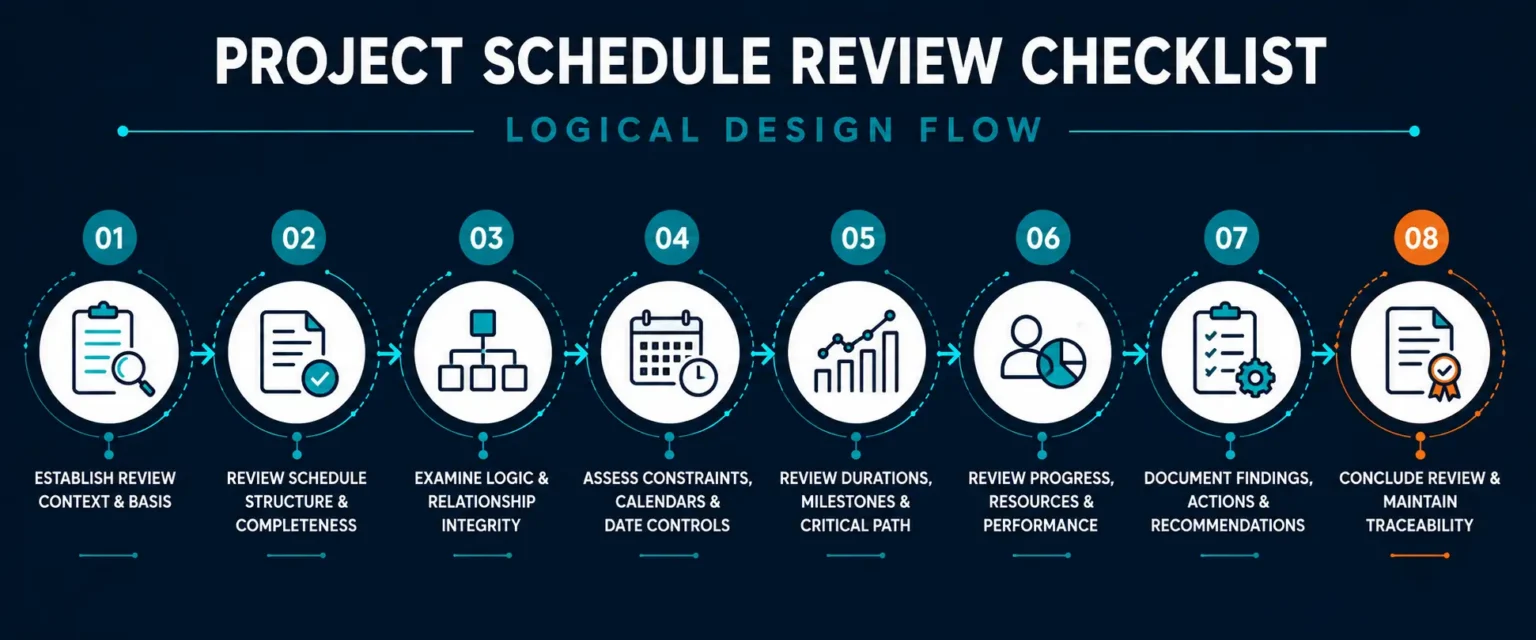

Project Schedule Review Checklist

Reviewing a project schedule requires a structured approach to examine its completeness, logic, time controls, critical path, progress, performance, and overall reliability. This Project Schedule Review Checklist provides a systematic framework to establish the review basis, validate schedule structure and relationships, assess constraints and date controls, examine durations and critical path, review progress and performance, and document findings and corrective actions.

Excel Checklist · Project Planning & Scheduling

ABOUT THE CHECKLIST

A Structured Framework for Reviewing Project Schedules

The Project Schedule Review Checklist is an Excel-based scheduling review tool designed to provide a structured and evidence-based method for examining the completeness, logic, time controls, critical path, progress, performance, and overall reliability of a project schedule. It helps project teams apply a consistent review approach while allowing project-specific requirements, procedures, contract conditions, and scheduling methodologies to take precedence.

The checklist connects project context and review criteria with schedule structure, logic, constraints, calendars, date controls, durations, milestones, critical path, resources, progress, performance, findings, corrective actions, and final review conclusions. This creates a clear record of what was reviewed, how each area was assessed, what evidence supported the findings, what actions are required, and whether the schedule can reasonably support project planning, monitoring, forecasting, and decision-making.

Establish Review Context

Define the project and schedule context, review scope, schedule purpose, applicable procedures, contractual requirements, schedule basis, standards, methodology, and other criteria that establish how the schedule should be reviewed.

Validate Schedule Structure

Review WBS, activities, milestones, activity attributes, coding, work packages, schedule levels, interfaces, completeness, and other structural elements to determine whether the schedule is appropriately organized for its intended purpose.

Examine Logic & Time Controls

Assess predecessors, successors, relationship types, open ends, lags, leads, constraints, calendars, working periods, data dates, project dates, and other controls to determine whether the schedule logically represents the planned sequence of work.

Assess Performance & Findings

Review durations, milestones, float, critical path, progress, resources where applicable, forecast information, and performance trends, then document evidence, findings, severity, priority, corrective actions, responsibilities, and review conclusions.

Project Schedule Review Checklist

WHAT’S INCLUDED

Everything You Need to Review and Validate a Project Schedule

The workbook brings project context, review criteria, schedule structure, logic, constraints, calendars, date controls, durations, critical path, progress, performance, findings, and corrective actions into one connected schedule-review framework. Each section supports a defined stage of examining schedule quality, reliability, and readiness.

01

Project Profile

Establish the project and schedule context, including schedule purpose, version, data date, project details, review scope, reviewer information, and other baseline or contractual information needed to define the review environment and review boundaries.

02

Review Setup & Criteria

Define the review scope, schedule type, applicable procedures, contractual requirements, schedule basis, project standards, review methodology, evidence sources, and applicability criteria used to evaluate the schedule consistently and objectively.

03

Schedule Structure & Completeness Review

Review WBS, activities, milestones, coding, attributes, work packages, schedule levels, interfaces, completeness, duplicate information, and other structural elements to determine whether the schedule is appropriately organized and complete for its intended purpose.

04

Schedule Logic & Relationship Review

Assess predecessors, successors, relationship types, open ends, leads, lags, constraints, interface logic, milestone relationships, out-of-sequence conditions, and network integrity to determine whether the schedule represents a credible and connected sequence of work.

05

Constraints, Calendars & Date Controls

Review constraints, calendars, working periods, non-working periods, exceptions, data date, project dates, contractual dates, forecast dates, and other date controls to determine whether schedule dates are generated, maintained, and controlled appropriately.

06

Durations, Milestones & Critical Path Review

Examine activity durations, duration basis, milestones, float, negative float, critical path, near-critical paths, driving activities, path continuity, and forecast completion to determine whether the time model provides a credible representation of project completion and schedule drivers.

07

Resources, Progress & Performance Review

Review progress methodology, actual dates, remaining duration, resources where applicable, productivity, progress trends, forecast changes, performance indicators, and recovery assumptions to determine whether the schedule reflects actual project conditions and provides a credible forecast.

08

Review Summary, Findings & Action Plan

Consolidate review results by recording findings, evidence, severity, priority, impact, recommendations, corrective actions, responsible parties, target dates, closure status, and the overall conclusion on schedule reliability, readiness, and required management attention.

HOW TO USE THE CHECKLIST

From Review Preparation to Actionable Schedule Findings

The checklist should be used as a structured review process rather than as a collection of independent questions. Start by identifying the schedule and review purpose, establish the applicable review criteria, examine the schedule systematically, record evidence and findings, assess their significance, and translate the results into corrective actions and a clear review conclusion.

1. Identify the Schedule

Begin with the Project Profile and confirm the project, schedule purpose, schedule version, data date, review date, reviewer, scheduling software, and available schedule references. Make sure the schedule being reviewed is clearly identified before beginning the technical assessment.

2. Establish the Review Basis

Use Review Setup & Criteria to define why the review is being performed and what requirements apply. Consider the contract, schedule specification, project procedures, schedule basis, internal standards, approved baseline, review scope, and available evidence before applying the checklist.

3. Review Structure & Completeness

Begin the technical review with Schedule Structure & Completeness Review. Examine whether the schedule contains the information, organization, activities, milestones, coding, work packages, interfaces, and other structural elements necessary for its intended planning and control purpose.

4. Examine Network Logic

Use Schedule Logic & Relationship Review to examine how activities connect and whether the planned sequence is credible. Review predecessors, successors, relationship types, open ends, leads, lags, constraints, milestone logic, interfaces, out-of-sequence conditions, and other network characteristics.

5. Examine Time Controls

Review Constraints, Calendars & Date Controls to understand how schedule dates are generated and maintained. Check constraints, calendars, working periods, exceptions, data date, project dates, contractual dates, forecast dates, and other mechanisms that may influence schedule behavior.

6. Assess Time & Critical Path

Use Durations, Milestones & Critical Path Review to examine the schedule’s time model and completion drivers. Consider duration realism, milestone integrity, float, negative float, critical and near-critical paths, driving activities, path continuity, and forecast completion before drawing conclusions.

7. Review Progress & Performance

Use Resources, Progress & Performance Review to compare the schedule with actual project conditions. Where applicable, examine actual dates, remaining duration, progress methods, resources, productivity, performance trends, forecast changes, and recovery assumptions to assess forecast credibility.

8. Record Findings & Actions

Complete Review Summary, Findings & Action Plan after the detailed review. Record evidence, assessment status, severity, priority, impact, recommendations, responsible parties, target dates, corrective actions, closure status, and the overall review conclusion.

Review the Schedule, Then Act

A schedule review becomes valuable when findings are supported by evidence and converted into clear actions. Use the checklist to move from review criteria and technical examination to documented findings, management priorities, corrective actions, and a reasoned conclusion on whether the schedule can support planning, monitoring, forecasting, and project decision-making.

PROJECT SCHEDULE REVIEW FRAMEWORK

Evaluate the Key Dimensions of a Reliable Project Schedule

A project schedule needs to connect structure, logic, time controls, critical-path analysis, progress, performance, and review findings into one practical management framework. The checklist provides a structured basis for examining whether the schedule is complete, logically connected, appropriately controlled, realistically time-phased, reflective of project conditions, and suitable for planning, monitoring, forecasting, and decision-making.

Project Context & Review Basis

Consider project identity, schedule purpose, version, data date, review scope, applicable procedures, contractual requirements, schedule basis, standards, methodology, and criteria that establish the basis for conducting the schedule review.

Schedule Structure & Completeness

Review WBS, activities, milestones, coding, attributes, work packages, schedule levels, interfaces, completeness, duplicate information, and structural elements needed to determine whether the schedule is appropriately organized for its intended purpose.

Logic & Relationship Integrity

Assess predecessors, successors, relationship types, open ends, leads, lags, constraints, milestone relationships, interfaces, out-of-sequence conditions, and network integrity to determine whether the schedule represents a credible and connected sequence of project work.

Constraints, Calendars & Date Controls

Review constraints, calendars, working periods, non-working periods, exceptions, data date, project dates, contractual dates, forecast dates, and controls that influence how schedule dates are generated, maintained, and appropriately controlled.

Durations, Milestones & Critical Path

Evaluate activity durations, duration basis, milestones, float, negative float, critical path, near-critical paths, driving activities, path continuity, and forecast completion to determine whether the time model provides a credible view of project completion.

Progress, Resources & Performance

Examine progress methods, actual dates, remaining duration, applicable resources, productivity, progress trends, forecast changes, performance indicators, and recovery assumptions to determine whether the schedule reflects current conditions and provides a credible forecast.

Findings, Actions & Review Conclusion

Record evidence, findings, severity, priority, impact, recommendations, corrective actions, responsible parties, target dates, closure status, and the overall conclusion regarding schedule reliability, readiness, and required management attention.

Evidence, Applicability & Traceability

Maintain clear links between review criteria, applicability decisions, assessment status, supporting evidence, findings, and corrective actions so the review remains clear, repeatable, traceable, and useful for management review and follow-up.

SCHEDULE REVIEW STATUS

Use Review Status to Classify Schedule Assessment Results

The checklist uses six structured assessment statuses to help reviewers consistently classify each review item, distinguish satisfactory conditions from deficiencies and observations, identify items outside the review scope, and clearly show areas that remain unassessed.

Conforming

Requirement Satisfied

The reviewed schedule element meets the applicable requirement, review criterion, project procedure, or expected condition, with sufficient evidence available to support the assessment and no significant issue requiring corrective action.

Partially Conforming

Requirement Partly Satisfied

The reviewed schedule element generally meets the applicable requirement but contains a limitation, inconsistency, weakness, or incomplete condition that should be addressed to improve schedule quality, reliability, or compliance.

Non-Conforming

Requirement Not Satisfied

The reviewed schedule element does not meet the applicable requirement or expected condition and represents a significant deficiency, weakness, or control issue that requires corrective action, further assessment, or management attention.

Observation

Improvement Opportunity

The reviewed schedule element does not necessarily represent a non-conformance but identifies an opportunity, practice, condition, or consideration that may improve schedule quality, transparency, reliability, or effectiveness.

N/A

Not Applicable

The review item does not apply to the schedule, project environment, review scope, scheduling methodology, or applicable requirements. The reviewer should provide an appropriate basis where necessary to explain its applicability decision.

Not Reviewed

Assessment Not Performed

The review item has not yet been assessed because the required information, evidence, access, or review activity is unavailable or the assessment remains outstanding within the defined review scope.

FROM SCHEDULE REVIEW TO ACTIONABLE FINDINGS

Turn a Project Schedule Review Into a Structured Assessment

A project schedule review requires more than checking whether activities and dates are present. The checklist connects project context with review criteria, schedule structure, logic, time controls, critical path, progress, performance, evidence, findings, and corrective actions to provide a consistent basis for assessing schedule quality and reliability.

Establish Review Context

Understand the Schedule Before Review

The checklist establishes the foundation for schedule review by bringing together the project profile, schedule purpose, schedule version, data date, review scope, applicable requirements, schedule basis, review methodology, and other criteria that determine how the schedule should be examined.

This creates a clear reference point before the technical review begins and helps ensure that the correct schedule, review scope, applicable requirements, and project-specific conditions are considered throughout the assessment.

Confirm the Review Basis
Define the applicable review scope, schedule type, contractual requirements, project procedures, schedule basis, standards, review methodology, evidence sources, and other criteria before assessing individual schedule characteristics and determining whether each review item applies.

Validate Schedule Structure
Examine WBS, activities, milestones, coding, attributes, work packages, schedule levels, interfaces, completeness, and other structural elements to determine whether the schedule is appropriately organized and sufficiently complete for its intended planning and control purpose.

Examine Schedule Logic
Review predecessors, successors, relationship types, open ends, leads, lags, constraints, milestone relationships, interfaces, out-of-sequence conditions, and network integrity to determine whether the schedule represents a credible and connected sequence of project work.

From Technical Review to Schedule Conclusion

Connect Review Findings With Corrective Action

A schedule review becomes useful when technical observations remain connected to evidence, assessment status, severity, priority, impact, corrective actions, and the final conclusion. The checklist provides a structured path from examining schedule characteristics to identifying actions while maintaining clear review traceability.

Review Time & Critical Path
Assess constraints, calendars, dates, durations, milestones, float, critical path, near-critical paths, driving activities, path continuity, and forecast completion to determine whether the schedule provides a credible representation of project time and completion drivers.

Review Progress & Performance
Examine progress methods, actual dates, remaining duration, applicable resources, productivity, performance trends, forecast changes, and recovery assumptions to determine whether the schedule reflects current project conditions and provides a credible forecast.

Document Findings & Actions
Record assessment results, supporting evidence, findings, severity, priority, impact, recommendations, responsible parties, target dates, and corrective actions so that identified schedule issues can be clearly communicated and managed.

Conclude & Maintain Traceability
Consolidate review results, confirm outstanding matters, record closure status, and document the overall conclusion so that the relationship between review criteria, evidence, findings, actions, and schedule reliability remains clear for management follow-up.

DESIGNED FOR FLEXIBLE USE

Adapt Schedule Review & Validation to Your Project Environment

Projects differ in their delivery methods, schedule structures, contractual requirements, planning standards, data requirements, review criteria, and operating environments. The checklist provides a consistent schedule-review framework while allowing structure, logic, dates, progress, performance, evidence, and findings to be adapted to each project.

Construction & Infrastructure

Adapt the framework to construction schedules, WBS structures, activity sequencing, milestones, calendars, constraints, interfaces, progress updates, critical paths, field conditions, contractual requirements, and schedule-quality reviews across project planning, delivery, control, and assurance.

Engineering, EPC & Manufacturing

Adapt the framework for engineering deliverables, procurement, fabrication, production, commissioning, technical interfaces, milestones, calendars, constraints, progress updates, critical paths, contractual requirements, and schedule-quality reviews across project planning, delivery, control, and assurance.

IT & Digital Projects

Use the framework for software delivery, technology implementation, development phases, testing, integrations, releases, dependencies, milestones, calendars, progress updates, critical paths, forecast dates, and schedule-quality reviews across digital project planning, delivery, control, and assurance.

Professional & Corporate Projects

Apply the framework to consulting engagements, business initiatives, organisational changes, internal projects, strategic programmes, milestone plans, dependencies, progress updates, forecast dates, governance requirements, and schedule-quality reviews across project planning, delivery, control, and assurance.

LEARN, APPLY & GET STARTED

Learn the Approach and Apply It to Your Project

Understand how to establish the project and review context, define review criteria, examine schedule structure and completeness, validate logic and relationships, assess constraints and date controls, review durations and critical path, evaluate progress and performance, and document findings and corrective actions using the structured workbook.

Project Schedule Review Checklist FAQs

What is a Project Schedule Review Checklist?

It is a structured Excel-based review tool for evaluating schedule completeness, logic, constraints, calendars, durations, critical path, progress, performance, findings, and corrective actions.

Project planners, schedulers, project controls professionals, project managers, PMO teams, consultants, contractors, engineers, and other stakeholders involved in schedule review and validation can use it.

The workbook covers project profile, review criteria, schedule structure, logic and relationships, constraints and calendars, durations and critical path, resources and progress, performance, findings, and action planning.

No. It provides a structured review framework and evidence-recording process. A competent reviewer must assess the schedule, apply project-specific requirements, evaluate findings, and make the professional determination.

Yes. It helps reviewers systematically examine structural completeness, network logic, open ends, constraints, calendars, durations, float, critical path, progress, forecast information, performance, and other schedule-quality considerations.

Yes. The checklist can be adapted to project-specific procedures, contractual requirements, scheduling methodologies, review criteria, applicability conditions, and other requirements relevant to the schedule being reviewed.

Yes. The framework can support construction, infrastructure, EPC, engineering, manufacturing, energy, IT, digital transformation, consulting, professional services, and other project environments.

Learn & Apply

Understand the Review Approach. Apply It to Your Schedule.

Learn the principles of project schedule review and validation through the related guide, then use the structured checklist to examine schedule quality, document evidence, classify findings, assign actions, and support a clear review conclusion.

Learn with the Guide
How to Review and Validate a Project Schedule

Learn how to systematically review schedule structure, logic, constraints, calendars, durations, critical path, progress, and performance while documenting evidence, findings, corrective actions, and review conclusions.

Apply with the Template
Project Schedule Review Checklist

Use the Excel-based framework to establish the review basis, examine schedule structure and logic, assess time controls and critical path, review progress and performance, and document findings and corrective actions.

FEATURED PROJECT PLANNING & SCHEDULING TEMPLATES

Templates for Common Planning & Scheduling Activities

Our featured templates provide practical starting points for common planning and scheduling activities. Each resource helps structure planning information, develop schedules, identify constraints, review schedule quality, or manage controlled changes.

Project Plan Development Template

Structure project planning information, including objectives, scope, deliverables, assumptions, constraints, responsibilities, execution requirements, and supporting plans for effective project delivery.

Work Breakdown Structure Template

Break project scope into logical work packages, helping teams organize deliverables, assign responsibilities, support estimating, develop schedules, and create a practical foundation for project control.

Project Schedule Basis Template

Document assumptions, methodologies, calendars, constraints, milestones, sequencing principles, exclusions, and other planning considerations that establish a clear basis for the project schedule.

MORE PROJECT PLANNING & SCHEDULING RESOURCE TYPES

Continue Your Project Planning & Scheduling Learning

Project planning and scheduling knowledge becomes more valuable when you can understand the concepts, apply structured approaches, and develop practical skills. Explore the other resources within the Project Planning & Scheduling collection to complement the guidance provided in these guides.

Looking for more project management resources? Explore the Kleios Technologies Resources Hub to discover our complete collection of guides, templates, downloads, career roadmaps, case studies, glossary resources, and insights.

RELATED KNOWLEDGE DOMAINS

Continue Your Learning Across Related Knowledge Domains

Project Management is closely connected with specialized disciplines that support successful planning, execution, governance, performance measurement, and professional growth. Explore related knowledge domains to expand your expertise, develop complementary skills, and access practical resources across the complete project management ecosystem.

Expand your expertise one domain at a time and build a well-rounded project management skill set.

Why Explore Related Domains?

Each knowledge domain complements your Project Management expertise, helping you build broader capabilities and solve real-world project challenges with greater confidence.
